You shipped the MVP. The demo works, a handful of real users signed up, and then the room goes quiet with one question: what comes after an MVP? The honest answer is that the launch was the cheap part. A minimum viable product exists to settle a single bet — does anyone actually want this — and settling it well is where most of the money, and most of the mistakes, live. Roughly 42% of failed startups die from building something with no market need (CB Insights' widely cited analysis of startup post-mortems), not from bad code. So the work after launch is not "add more features." It is figuring out whether you have a business, then earning the right to scale it.
This is the post-MVP process we run at Fora Soft after 250+ product launches since 2005: measure fit, read the funnel, rank the work, harden what you built fast, and keep the users you already won. It is a loop you repeat every sprint, not a checklist you finish once. Below is each phase, the numbers that tell you the truth, a worked cost example, and a decision tree for the moment the data says scale, iterate, pivot, or stop.
Key takeaways
• The MVP answered one question; now prove fit. Before adding features, measure product-market fit with the Sean Ellis 40% test and a flattening retention curve.
• Instrument first, opinions second. Wire up the AARRR funnel so you fix the biggest leak instead of the loudest complaint.
• Rank ruthlessly. Score the backlog with RICE or MoSCoW; ship quick wins now, schedule big bets, skip time sinks.
• Harden what you rushed. An MVP trades polish for speed; pay down the risky debt before load, not after an outage.
• Know when to stop. If fit never shows up, pivot to the segment that loves it or kill it cleanly — that is a win, not a failure.
What comes after an MVP
What comes after an MVP is a five-phase loop, run every two to six weeks: measure product-market fit, instrument the product to read behaviour, prioritize the backlog, build and harden the next slice, and retain the users you already have. The MVP proved the idea was worth testing; the post-MVP loop turns that signal into a product people pay for and stick with. Skip a phase and you get the classic failure mode: teams that keep bolting on features while their retention quietly bleeds out.

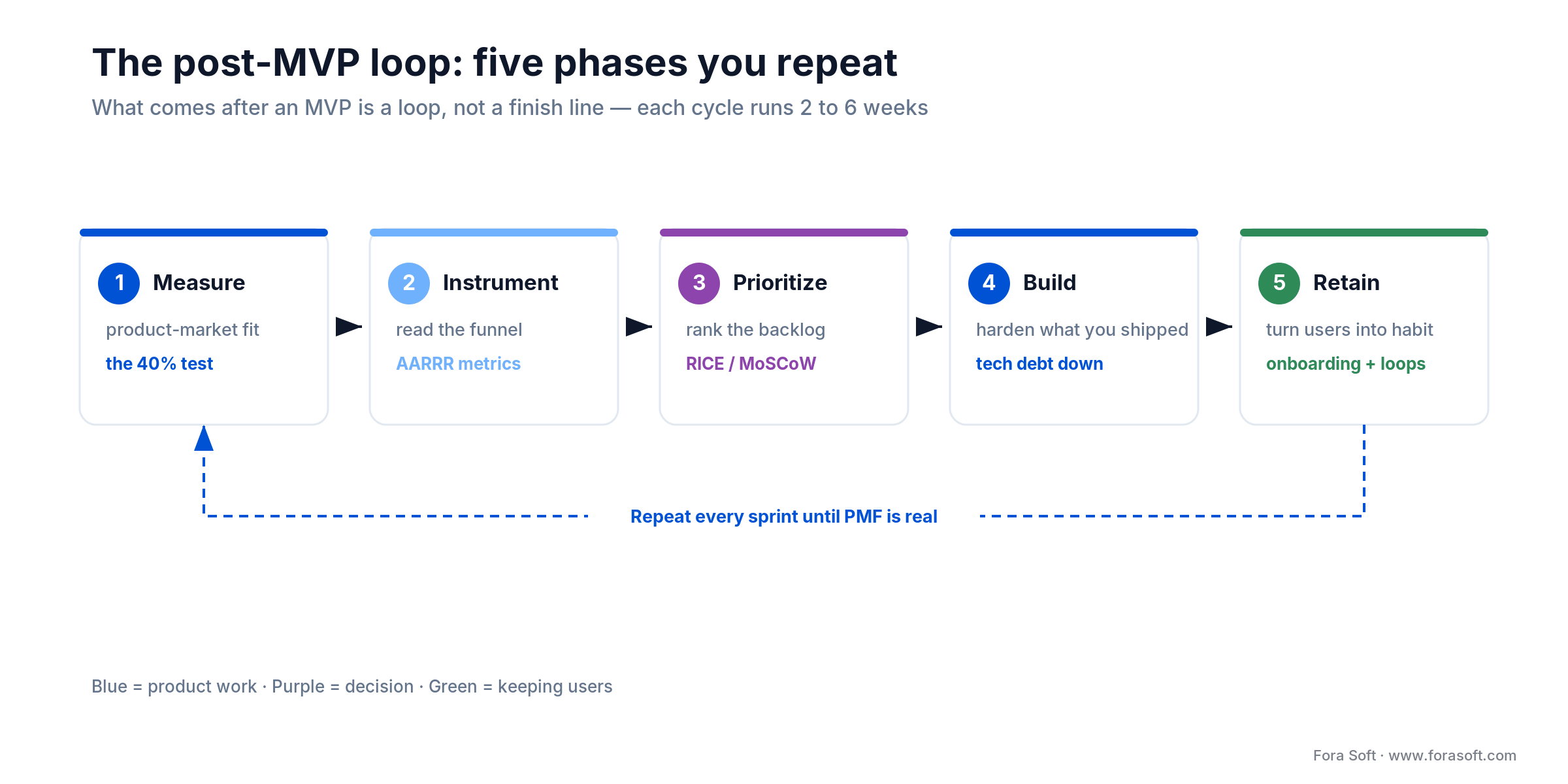

Figure 1. The five phases you repeat after launching an MVP. It is a loop, not a finish line.
Each turn of the loop should end with a decision, not just a shipped feature. Did retention move? Did the activation rate climb? If the numbers say yes, you invest more. If they stay flat after a few honest cycles, you change the product or the target, which we cover in the decision framework further down. The phases below are ordered the way we actually run them, because instrumenting before you measure, or scaling before you retain, wastes the runway you have left.
Reach for this loop when: your MVP is live with real users and you are tempted to jump straight to a big feature roadmap. Run one full cycle first; the data usually rewrites the roadmap you were about to build.
Not sure your MVP is ready to scale?
Book a 30-minute call and we will read your funnel with you and flag the one number that decides your next move.
Why Fora Soft wrote this playbook
We are a software studio that has built 250+ products since 2005, most of them taken well past the first release into paying, scaling businesses. We have sat in the post-MVP seat many times: the version-one code is creaking, users are asking for ten different things, and the founder has to decide where the next dollar goes. This playbook is what we wish every client had before that meeting.
One example we know intimately is BrainCert, a virtual-classroom platform we have built and scaled as the long-term engineering team. It started as a focused MVP — live HTML5 classrooms over WebRTC — and grew, feature by measured feature, into a 300-plus-feature product bootstrapped to roughly $3M in annual revenue. None of that came from guessing. It came from shipping a slice, watching how it was used, and repeating. We reference BrainCert and other real projects throughout, and we link the primary sources for every framework so you can check our work.
Measure product-market fit before you build more
The first thing after an MVP is not a feature; it is a verdict on fit. Product-market fit means a defined group of users would be genuinely upset to lose your product. The cleanest way to measure it is the Sean Ellis test: ask active users "how would you feel if you could no longer use this product?" and count the share who answer "very disappointed." At or above 40%, you have a signal worth scaling behind; below 25%, keep iterating or rethink the target. Ellis landed on that threshold after surveying close to 100 startups.
That single question is powerful because it filters for intensity, not politeness. The Superhuman team turned it into a repeatable engine: they segmented the "somewhat disappointed" users, found what the "very disappointed" cohort had in common, and rebuilt onboarding and the roadmap around that cohort — moving their score from 22% to 58% in about a year. Survey only your active users, not everyone who ever signed up, or you will measure the wrong crowd.
Retention is the other truth serum, and it is harder to fake than a survey. If a cohort of new users keeps coming back and the retention curve flattens into a stable plateau, value is real. A month-one retention rate around 39% is a positive sign for a young software product, and the top decile of products retain close to 1.7 to 1.9 times the average through the first three months (Pendo benchmarks, 2025). Before any of this, get out of the building and talk to users the way the Steve Blank customer-development method prescribes: open questions, present tense, no leading them to your answer. Our analytical-stage guide covers how we structure those interviews.
Reach for the 40% test when: you have at least a few hundred activated users and need one honest read on fit before committing budget to growth. Fewer than that, and interviews plus a raw retention curve tell you more than a survey.
Instrument the product: read the AARRR funnel
You cannot fix what you cannot see. Before the next build phase, wire up product analytics so every stage of the user path emits an event. The standard frame is AARRR, or "pirate metrics," from Dave McClure in 2007: Acquisition, Activation, Retention, Referral, Revenue (the Amplitude explainer is a good primer). Each stage is a smaller cohort than the last, so your job is to find the biggest leak and plug that one first.

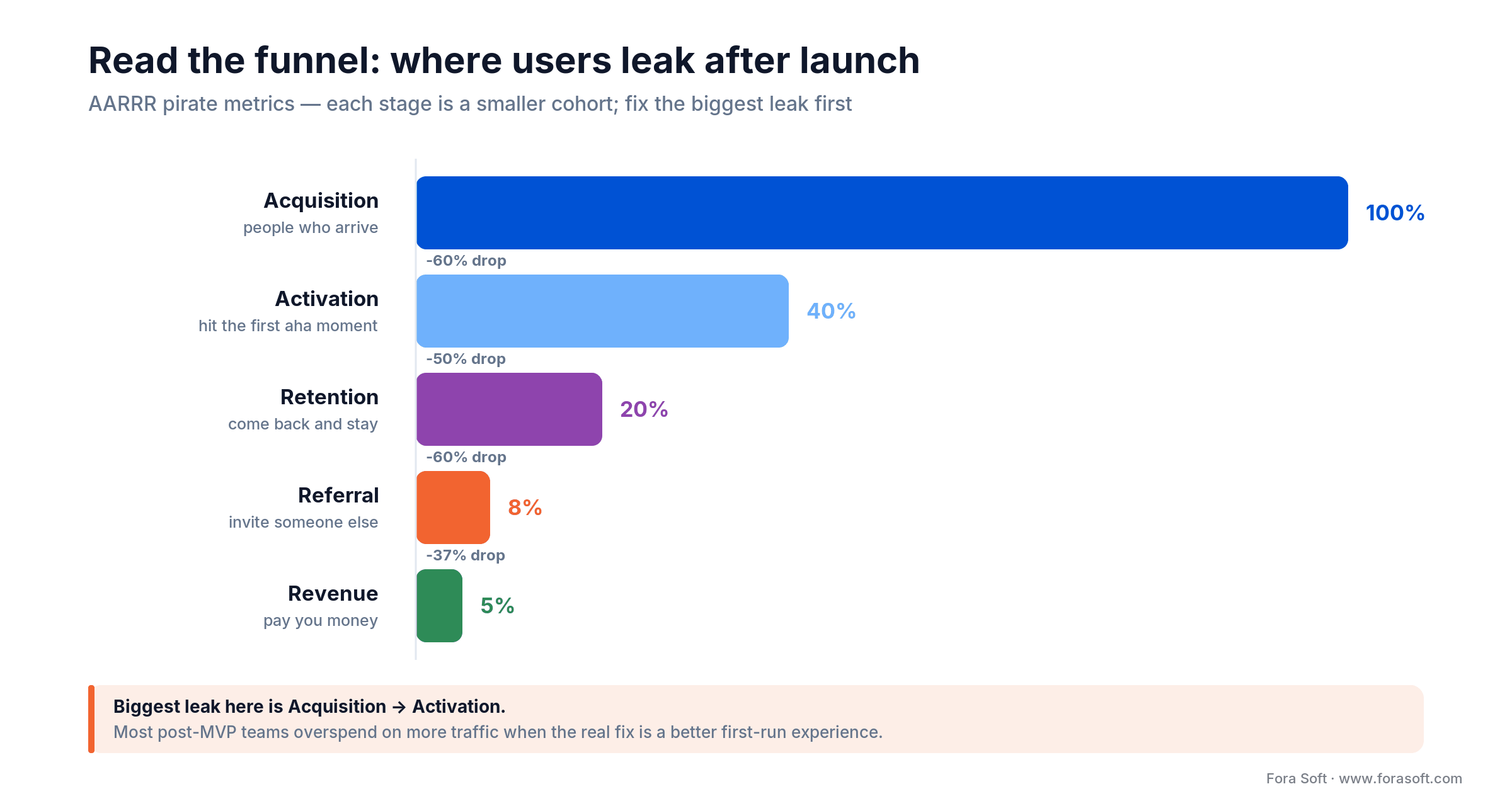

Figure 2. How the funnel narrows after launch. The steepest drop is usually acquisition to activation.
For most post-MVP products the steepest drop sits between acquisition and activation: people arrive, poke around, and never reach the moment the product clicks. That is the expensive lesson hiding in the funnel, because the instinct is to buy more traffic when the real fix is a better first run. Pick tooling that shows you funnels and cohorts out of the box (Mixpanel, Amplitude, PostHog, or GA4 for a lean start) and define your activation event precisely: not "signed up," but "did the thing that delivers value," like sent a first message or published a first course.
Instrumentation pays for itself fast because it kills debates. Instead of arguing about which feature to build, you look at where the cohort falls off and follow the money. We wrote a longer piece on how early analytics saves time and money on a product build; the short version is that a week of event tracking usually saves a month of building the wrong thing.
Reach for analytics tooling when: you are about to prioritize the roadmap. Ranking features without funnel data is guessing with extra steps; one clear drop-off chart settles most arguments in the room.
The metrics that actually matter after launch
Downloads and signups feel good and mean little. After an MVP, track a small set of numbers that tie to whether users get value and whether the business works. Here is the shortlist we watch, what each one answers, a healthy early signal, and the trap that makes the metric lie.
| Metric | What it answers | Healthy early signal | The trap |
|---|---|---|---|
| Activation rate | Do new users reach the aha moment? | Trending up week over week | Counting signups, not the value event |
| Week-4 retention | Do they come back and stay? | A cohort curve that flattens, not one that hits zero | Counting logins instead of real use |
| Monthly churn | How fast do you lose them? | Roughly 3-5% for early B2B; lower is better | Ignoring involuntary (failed-card) churn |
| PMF score (40% test) | Would users be very disappointed to lose it? | 40%+ says fit; 25-40% is close | Surveying everyone, not active users |
| CAC vs LTV | Can you afford to grow? | A path toward roughly 1:3 once data is real | Computing LTV before you have retention |
| Referral / organic pull | Do users bring other users? | Any unpaid word of mouth | Buying incentivized, fake referrals |
Pick one leading number as your North Star — the single metric that best captures delivered value, like weekly active teams or lessons completed — and make the whole team watch it. Everything else is a supporting cast that explains why the North Star moved.
Turn feedback into a ranked backlog
After launch the backlog explodes: every user wants something different, and every one of them sounds urgent. You will not build it all, so the skill is ranking. Two scoring methods cover most cases. RICE multiplies Reach, Impact, and Confidence, then divides by Effort, which forces a number onto gut feel; Intercom created it for exactly this problem. MoSCoW is faster and blunter: sort each item into Must, Should, Could, or Won't-have-this-time, and protect the Musts.
A third option, the Kano model, is worth knowing when you are choosing between table-stakes fixes and delighters. the Intercom RICE write-up is the canonical source if you want the formula and a spreadsheet. Whichever you pick, score every idea and plot it, because the visual sorts the work faster than any list.

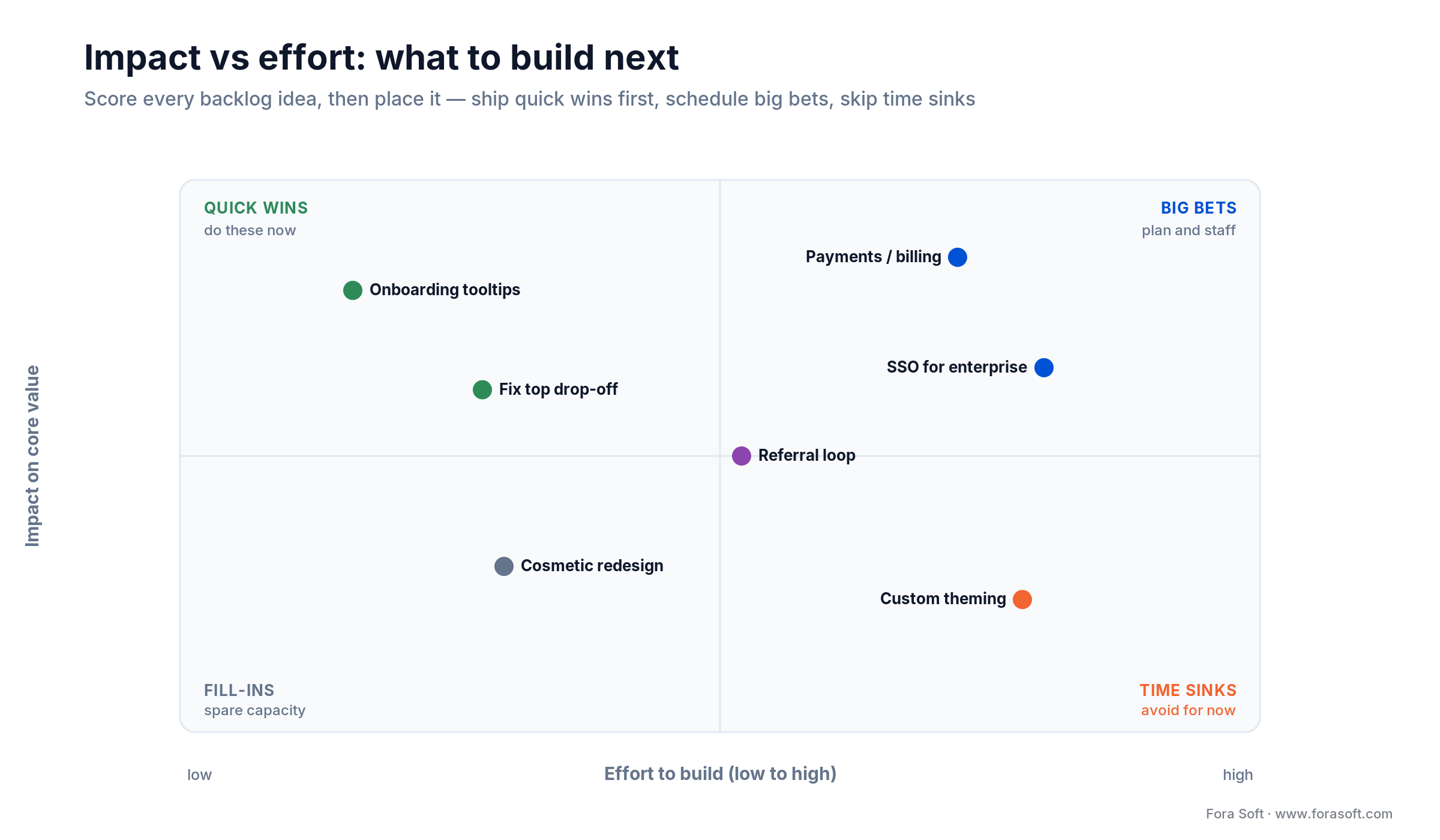

Figure 3. Score each backlog item, then place it. Quick wins ship now; time sinks wait or die.
| Method | Inputs | Best when | Watch out |
|---|---|---|---|
| RICE | Reach x Impact x Confidence / Effort | You have data and several comparable ideas | Fake precision from made-up numbers |
| MoSCoW | Must / Should / Could / Won't | You need a fast call with the team | Everything creeps into “Must” |
| Kano | Basic vs performance vs delighter | Balancing fixes against wow features | Survey overhead for small backlogs |
| ICE | Impact x Confidence x Ease | A quick first pass before RICE | Too coarse for close calls |
One rule saves you from thrash: do not build every request. If you chase each piece of feedback you will rework the same screens back and forth and burn the runway. Show users their voice matters by shipping the highest-scored items, and let the rest sit until the data promotes them.
Reach for RICE when: two or more features look equally worthy and the team keeps arguing. Reach for MoSCoW when you need the call before lunch and the stakes are lower.
Drowning in a post-launch backlog?
We will help you score it, cut it to what moves your North Star, and sequence the next quarter of work.
Harden what you built fast
An MVP buys speed by borrowing against quality, and that loan comes due right after launch. The first real users expose the shortcuts: the endpoint that melts at 200 concurrent sessions, the sign-up that breaks on one browser, the schema that made sense at ten records and not at ten thousand. Hardening is the unglamorous phase that keeps a growing product from face-planting in public.
Prioritize the debt by blast radius, not by how much it annoys engineers. Fix the things that can lose data, leak information, or take the product down under load. Put real numbers on it: measure current response times and requests per second, then set a target headroom in the architecture before the user base grows into it. Add monitoring and alerts so you learn about failures from a dashboard, not from an angry customer.
Security and compliance move from "later" to "now" the moment you handle real user data. If your product touches health, payments, or education, the standards (HIPAA, PCI DSS, GDPR, SOC 2) are not optional and are far cheaper to build in than to retrofit. If your MVP is media-heavy — video, streaming, real-time calls — the engineering fundamentals are unforgiving; our Learn library breaks them down, starting with what digital video actually is. When it is time to add senior hands or a second team, that is what our custom software development practice exists for.
Reach for a hardening sprint when: a single outage or data bug would cost you the trust you just earned. If nothing in the stack can lose data or fall over under 10x load, keep shipping features and revisit later.
Fix activation and retention
The cheapest growth is the users you already have. Two levers move the needle here: getting more new users to the aha moment (activation) and getting activated users to come back (retention). Better onboarding alone can lift first-year retention by around 25%, and products where users adopt 70%-plus of core features retain at roughly double the rate (Pendo, 2025).
Onboarding to the first win
Good onboarding is not a product tour; it is the shortest path to the first real outcome. Strip steps until a new user reaches value in as few clicks as possible, then measure how many make it. If your flow assumes three steps and users take ten with detours, the interface is unclear at exactly those points. Watching a handful of first-run sessions on video shows you the friction a written report hides.
Habit loops that pull users back
Retention comes from earned reasons to return, not from nagging. Notifications and email digests work when they carry genuine value (a reply, a result, a reason) and annoy when they do not. A referral loop turns happy users into a channel by rewarding them for bringing a friend; nothing markets a product like personal gain plus a nudge. Match the copy and tone to who you serve, so the product sounds like it was made for them.
MVP to MMP to MLP: what “next” means
"After the MVP" has names. The MVP tested whether the problem is real. The next rung is usually the Minimum Marketable Product (MMP): the smallest version good enough to sell, with the rough edges filed down and a price attached. Beyond that sits the Minimum Lovable Product (MLP), the smallest version users actively love rather than merely tolerate. At Fora Soft our first release is often already an MLP, because lovability compounds retention. If you need the definitions from the start, our guide to what an MVP is covers the ground, and the Lean Startup guide frames the MVP as the fastest loop through build-measure-learn.
The ladder matters because it sets the bar for "done" at each stage. An MMP that is merely usable will lose to a competitor's MLP that is a joy to use. Decide which rung you are climbing this quarter, and hold the work to that standard rather than piling on features that no rung actually needs.
What the first 90 days after MVP cost
Post-MVP work has a price, and pretending it is free is how runways end early. Here is an illustrative first quarter for a small team — ranges, not a quote, because the real number depends on your stack and scope. Picture four people (two engineers, a part-time designer, a part-time product lead) for about 14 weeks: call it 56 person-weeks of effort. Figure 4 shows a sane split of that effort across the work.

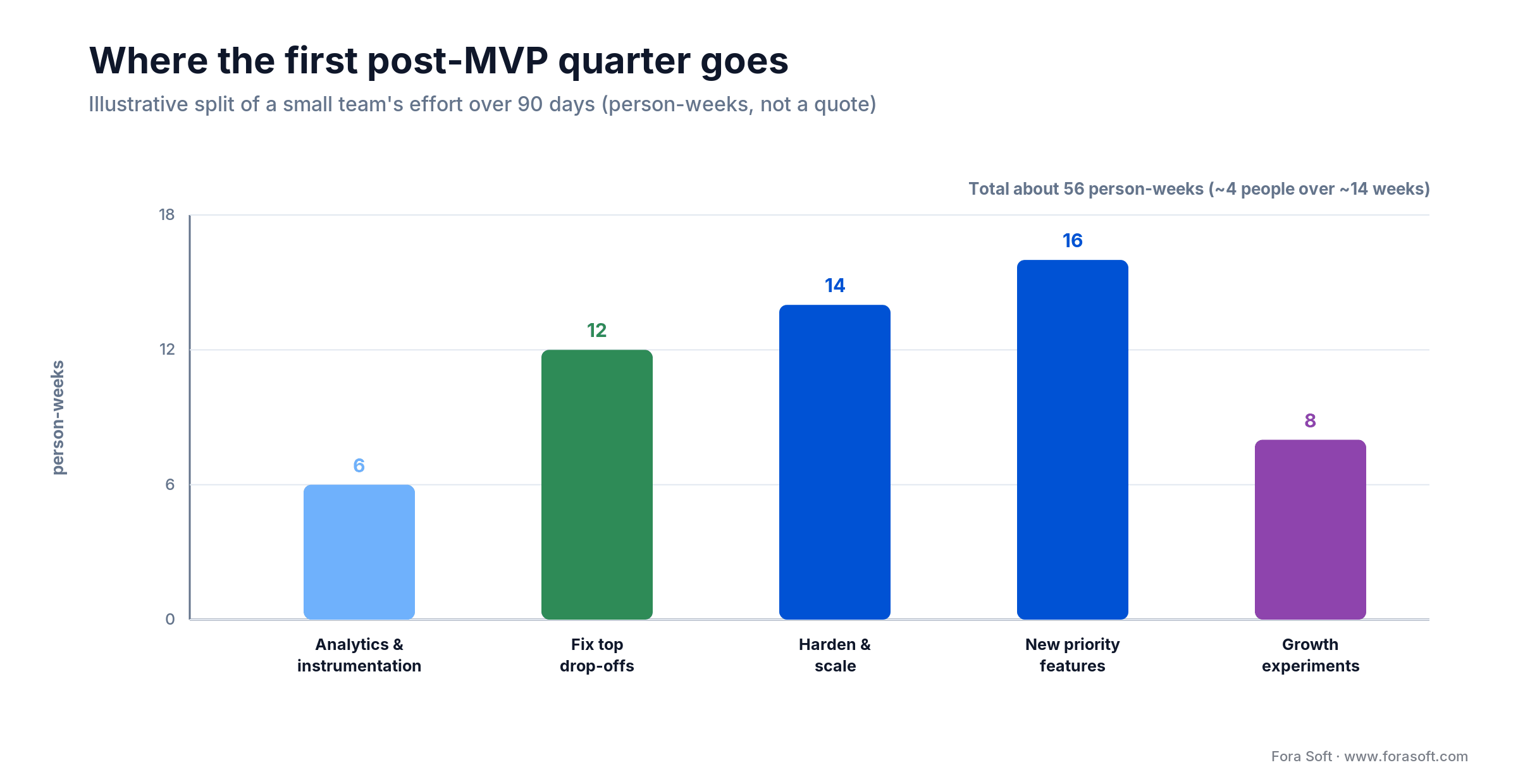

Figure 4. An illustrative split of a small team's first 90 days after MVP, in person-weeks.
The arithmetic, done out loud: at a conservative blended market rate near $60 per hour and roughly 35 productive hours per person-week, 56 person-weeks lands around $118,000 for the quarter (56 x 35 x $60 ≈ $117,600). Because we use Agent Engineering — AI-assisted delivery that compresses the routine work — our real quotes typically come in under a market number like that, not above it. Add third-party costs that scale with usage: analytics, cloud hosting, email, and a payments processor, often a few hundred to a few thousand dollars a month at this stage.
The point of the math is not the exact figure; it is that you can budget against it and know when to raise or cut. If the funnel says one workstream is not paying off, move those person-weeks somewhere that is. If cash is tight, our notes on cutting costs on a software project show where to trim without breaking the product. When you are unsure of a number, do not publish it; a wrong estimate is worse than an honest range.
Mini-case: BrainCert from MVP to $3M ARR
BrainCert is the clearest post-MVP story we can point to. The situation: a founder with a sharp idea — a virtual classroom that runs in the browser over WebRTC — and a first version that proved teachers would show up and teach. No outside funding, a small team, and a giant, crowded e-learning market on the other side.
The plan was the loop in this article, run for years. Ship a focused slice, instrument it, watch which features earned real use, harden the parts that carried live class traffic, and only then add the next capability. Interactive whiteboard, proctored exams, an e-commerce storefront, DRM content protection, a branded mobile app: each one added because the data and the customers asked for it, not because a roadmap said so.
The result: revenue grew from about $1.5M (2021) to $1.9M (2023) to roughly $3M in 2024, up 58% year over year, with 100K-plus customers and over 500 million real-time classroom minutes delivered at 99.995% uptime. The product now carries 300-plus features, but every one of them stands on a measured decision. Its CEO put it plainly: "Their work is outstanding in every aspect — from designing the technical architecture to programming, they do it all for us." Want a similar read on your product? Book a 30-minute call and we will map your next three moves.
Find one repeatable growth channel
You do not need ten marketing channels after an MVP; you need one that works and pays back. Use what your user interviews told you about where your audience already spends attention, then run a small, timeboxed test before you commit budget. Write the bet as a SMART hypothesis: "paid social will drive 100 installs in two weeks at under $6 each." Specific and falsifiable beats "let's try TikTok."
Run the test for about two weeks, watch it daily, and let the numbers decide. If a channel misses, reallocate; if it hits, model it out: "with $X I get Y activated users and Z demo requests," which is how you forecast ROI instead of hoping for it. Keep the brand consistent across whatever channels you pick so the product looks like one thing. Startup directories such as Product Hunt still earn early feedback and a trust badge, and our process notes on planning and scoping explain how we sequence this work with the build.
A decision framework in five questions
Every few cycles, step back and make an explicit call: scale, iterate, pivot, or kill. The point is to decide on evidence, not on sunk cost or founder mood. Walk the tree in Figure 5 from the top, and answer honestly.

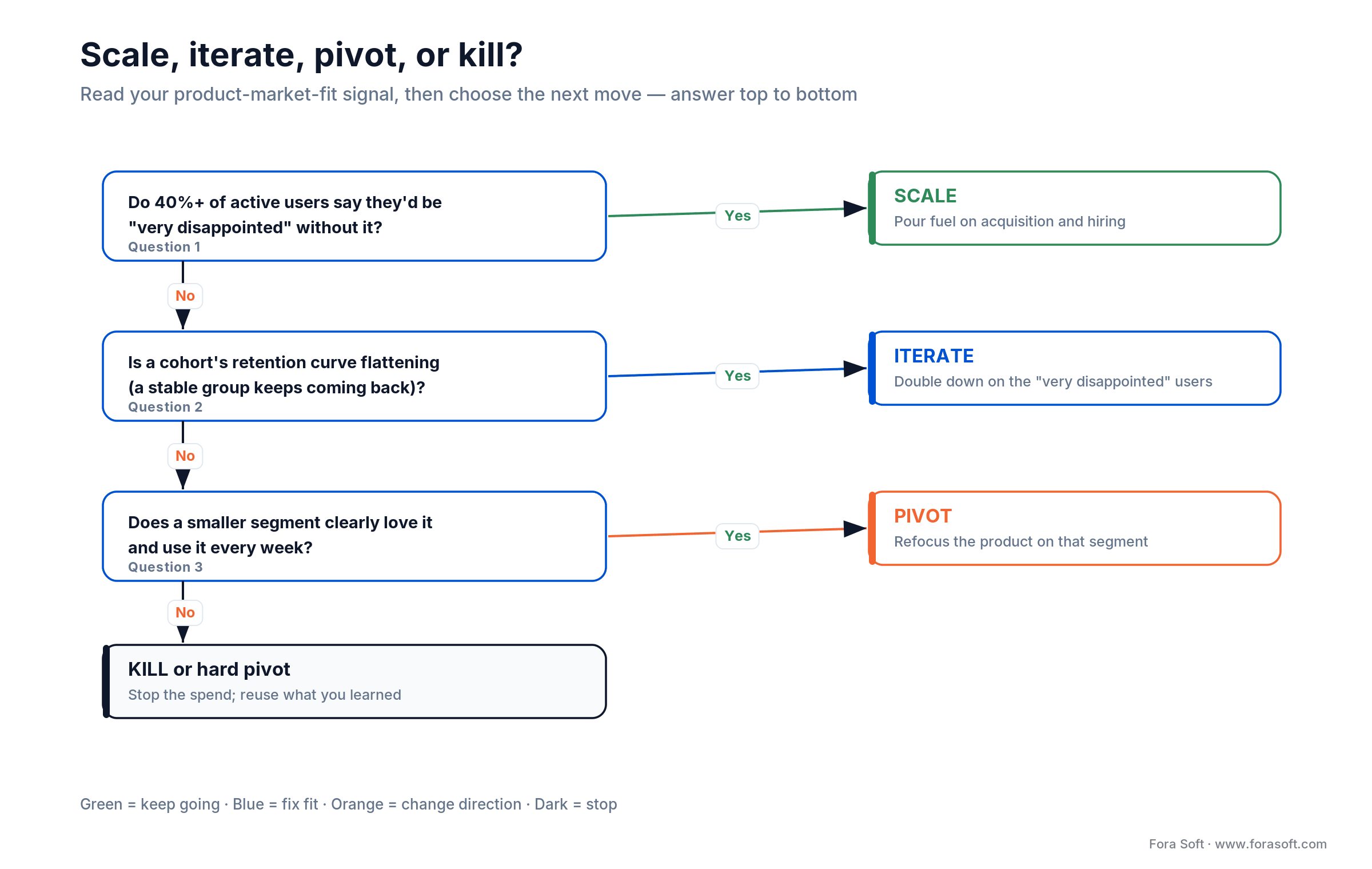

Figure 5. Read your product-market-fit signal, then choose: scale, iterate, pivot, or stop.
1. Do 40%+ of active users say they would be very disappointed without it? If yes, you have fit worth pressing. Pour effort into acquisition and hiring and go.
2. Is a cohort's retention curve flattening? If a stable group keeps returning, you are close. Double down on what the "very disappointed" users love and iterate toward the threshold.
3. Does a smaller segment clearly love it? If one niche is thrilled while the broad market shrugs, pivot the product to that segment rather than diluting it for everyone.
4. Have you given it enough honest cycles? Two or three real loops with real changes, not two weeks of hoping. If you have, and none of the above is true, stop spending.
5. What can you reuse? A kill is not a loss if the team, the code, and the lessons feed the next bet. Killing cleanly protects the runway for the idea that will work.
Five pitfalls that sink post-MVP products
1. Feature-chasing before fit. Adding features to a product no one is retained on just makes a bigger thing no one keeps. Prove fit first; features amplify fit, they do not create it.
2. Building for the loudest user. The person who emails most is not your market. Weigh feedback by how many users share the pain and how it maps to your funnel, not by volume.
3. Scaling spend on a leaky funnel. Buying traffic when activation is broken pours water into a bucket with a hole. Fix the biggest leak before you turn up acquisition.
4. Ignoring the debt until it bites. The shortcut that shipped the MVP will cause the outage that costs you trust. Pay down data-loss and scale risks on your schedule, not the incident's.
5. Never deciding. Drifting for a year without a scale-iterate-pivot-kill call is the quiet killer. Put the decision on the calendar and make it on the numbers.
When NOT to scale your MVP yet
Scaling a product that has not earned it is one of the more expensive mistakes in startups, so here is the honest counter-position. Do not scale if your retention curve still slopes toward zero: more users will churn just as fast, and you will have paid to acquire them. Do not scale if activation is under control of a manual step you are doing by hand for each customer; automate first or the wheels come off at volume.
Do not scale if your unit economics are unknown or upside down — if it costs more to serve a user than they return, growth multiplies the loss. And do not scale on a single big customer's roadmap; building only what one logo wants can march you away from the broader market. Staying small and sharp for another cycle is often the fastest path to a product actually worth scaling. Honesty about this is not weakness; it is how the runway survives.
KPIs: what good looks like
Product-health KPIs. Activation rate, week-4 cohort retention, and feature adoption of your core actions. These tell you whether the product delivers value and keeps it. Watch the cohort curve flatten; that plateau is the signal that matters.
Business KPIs. Monthly recurring revenue, customer acquisition cost against lifetime value, and conversion from free to paid. These tell you whether value turns into a business. Do not compute lifetime value until you have enough retention data to make it real.
Reliability KPIs. Uptime, error rate, and p95 latency on your core flows. These tell you whether the product can carry the growth you are chasing. A rising error rate under load is a scale problem wearing a small disguise; treat it before it becomes an outage.
How to fund the next stage
The post-MVP phase costs money before it makes much, so plan the fuel. If the numbers are trending right, this is the moment traction data does the talking: a flattening retention curve, a climbing activation rate, and a credible North Star are what investors actually buy. Package those honestly rather than dressing up vanity metrics, which experienced investors discount on sight. Our guide to getting investment for your app walks through what to show and when.
Not every product needs venture money, and many should not take it. Revenue can fund the next rung if your economics work, and bootstrapping keeps you honest about fit — BrainCert reached $3M in revenue without a funding round. Whichever route you choose, size the raise or the reinvestment against the 90-day budget math above, so you are funding a plan, not a vibe.
FAQ
What comes after an MVP?
A five-phase loop you repeat each sprint: measure product-market fit, instrument the product to read user behaviour, prioritize the backlog, build and harden the next slice, and improve retention. The MVP tested the idea; the post-MVP loop turns that signal into a product people pay for and keep using.
How do I know if my MVP is successful enough to scale?
Look for product-market fit, not just signups. Run the Sean Ellis test: if 40% or more of active users would be very disappointed without the product, and a user cohort's retention curve flattens instead of falling to zero, you have earned the right to scale. Below 25% on the test, keep iterating.
What comes after an MVP in agile?
In an agile setup, the post-MVP work is the same loop expressed as sprints: each iteration measures behaviour, re-ranks the backlog with RICE or MoSCoW, ships the next highest-value slice, and reviews the metrics. The MVP is the first increment; every following sprint is build-measure-learn on the release.
What is the difference between MVP, MMP, and MLP?
An MVP is the smallest version that tests whether the problem is real. An MMP (Minimum Marketable Product) is the smallest version good enough to sell. An MLP (Minimum Lovable Product) is the smallest version users actively love. Most teams climb MVP to MMP to MLP as retention and polish improve.
How long does it take to reach product-market fit after an MVP?
It varies widely and often takes several iterations over many months, sometimes a couple of years. The honest answer is that it takes as many build-measure-learn cycles as it takes; teams that decide on evidence each cycle get there faster than teams that add features and hope.
Which metrics matter most right after launch?
Activation rate, cohort retention (week-4 is a good anchor), churn, a product-market-fit score, and CAC against LTV. Downloads and raw signups are vanity numbers on their own. Pick one North Star metric that captures delivered value and make the whole team watch it.
Should I add features or fix the existing product first?
Fix first, usually. If activation and retention are weak, new features just add surface area to a product users do not keep. Prioritize the biggest funnel leak and the riskiest technical debt; add features once the core is retaining users and the debt is under control.
When should I pivot or kill the product instead of scaling?
Pivot when a smaller segment clearly loves the product while the broad market shrugs; refocus on that segment. Kill or hard-pivot when you have run several honest cycles, retention still falls to zero, and no segment shows real love. Stopping cleanly preserves the runway and the lessons for the next bet.
