Key takeaways
• Budget 10–15% of the project for planning. Standish CHAOS data says only about one in three software projects ships on time and on budget — and the biggest single cause of failure is poor requirements.
• A good plan is a stack of artifacts, not a deck. PRD, user-story map, wireframes, clickable prototype, MVP scope, risk register, and a range-based estimate — all written, all versioned, all signed off.
• Fixing a defect costs 6× in development and up to 100× in maintenance. Catching it on a wireframe is where the math works. Spend the time upfront or pay 100x later — there is no middle path.
• MVP means maximum validated learning, not “feature-light v1”. Ship the smallest slice that can prove or disprove your riskiest assumption; everything else is v1.1.
• AI and Agent Engineering compress planning by 30–40%. Faster PRD drafting, automated wireframe iteration, and real-time research synthesis let teams like Fora Soft deliver discovery in 3–4 weeks instead of 6, at comparable or better quality.
Why Fora Soft wrote this software planning playbook
Fora Soft has shipped more than 625 software products over the last 20+ years, and we have run the discovery phase on every single one of them. The playbook below reflects what actually works for founders — what we do on day one of an engagement with a new client, in what order, with which deliverables, and what we charge for it. It is not aspirational; it is our production checklist.
A few concrete projects that shape the advice here: BrainCert, a learning platform we have been planning and building for over a decade, has grown from a single-feature idea into a $10M ARR product serving 100,000+ customers across 500M+ minutes of live classes. AppyBee went from wireframes to 800+ fitness-centre customers with a 20% retention lift after its planned MVP scope. VALT launched into 770+ law-enforcement and medical organisations on top of a planning phase that mapped every compliance edge case before a single line of production code was written.
Those outcomes were built on discipline at the planning stage, not heroics in the delivery stage. This article packages that discipline. If you would rather skip straight to applying it to your project, our product planning service runs a 3–5 week structured discovery with a senior product strategist, a solutions architect, and an Agent Engineering pair.
Got a software idea but unsure how to scope it?
Book a free 30-minute planning call — a senior Fora Soft strategist will pressure-test your idea, sketch an MVP scope, and tell you honestly whether it is an 8-week or a 24-week build.
Why software projects fail — and why planning fixes most of it
The data is brutal. The Standish Group CHAOS report consistently finds that only about 31% of software projects fully succeed (delivered on time, on budget, and with the promised scope). Half are “challenged” — delayed, over budget, or descoped — and roughly 19% are outright cancelled. Projects over $10M are about 10× more likely to be cancelled than projects under $1M. McKinsey’s large-scale IT study adds that enterprise projects run on average 45% over budget, 7% over time, and deliver 56% less value than expected.
When researchers dig into root cause, one answer dominates: bad requirements. The Project Management Institute has reported that around 71% of embedded software projects fail due to poor requirements management. Infotech tracks the same pattern in general IT: unclear requirements trigger about 70% of project failures, and roughly half of all projects require rework for the same reason. This is not a bug in the industry; it is the single biggest lever a founder has.

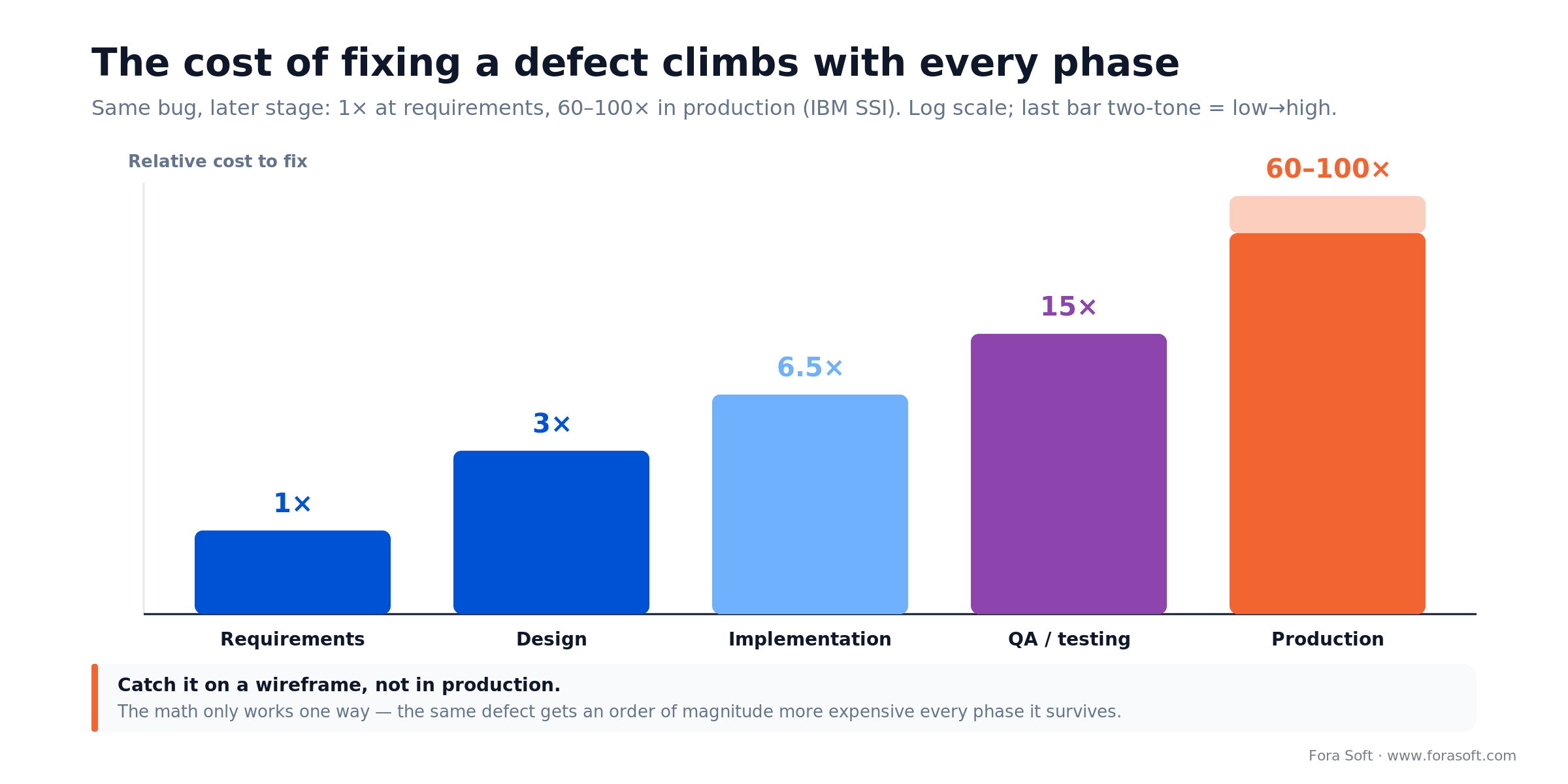

The cost math follows directly. IBM’s Systems Sciences Institute benchmark — widely cited and still holding up — shows that fixing a defect during requirements costs 1×, during implementation about 6.5×, during QA about 15×, and in production 60–100×. The Consortium for Information & Software Quality (CISQ) puts the total US cost of poor software quality at around $2.41 trillion a year, most of it traceable to shortcuts taken at planning time. This is why planning is not a “nice to have” — it is the single highest-leverage activity in the entire project.
Reach for heavier planning when: the project budget crosses $75k, touches regulated data (HIPAA, GDPR, PCI, SOC 2), has 3+ stakeholder groups, or depends on an integration you have not built before.
The planning arc — from napkin sketch to green-lit MVP

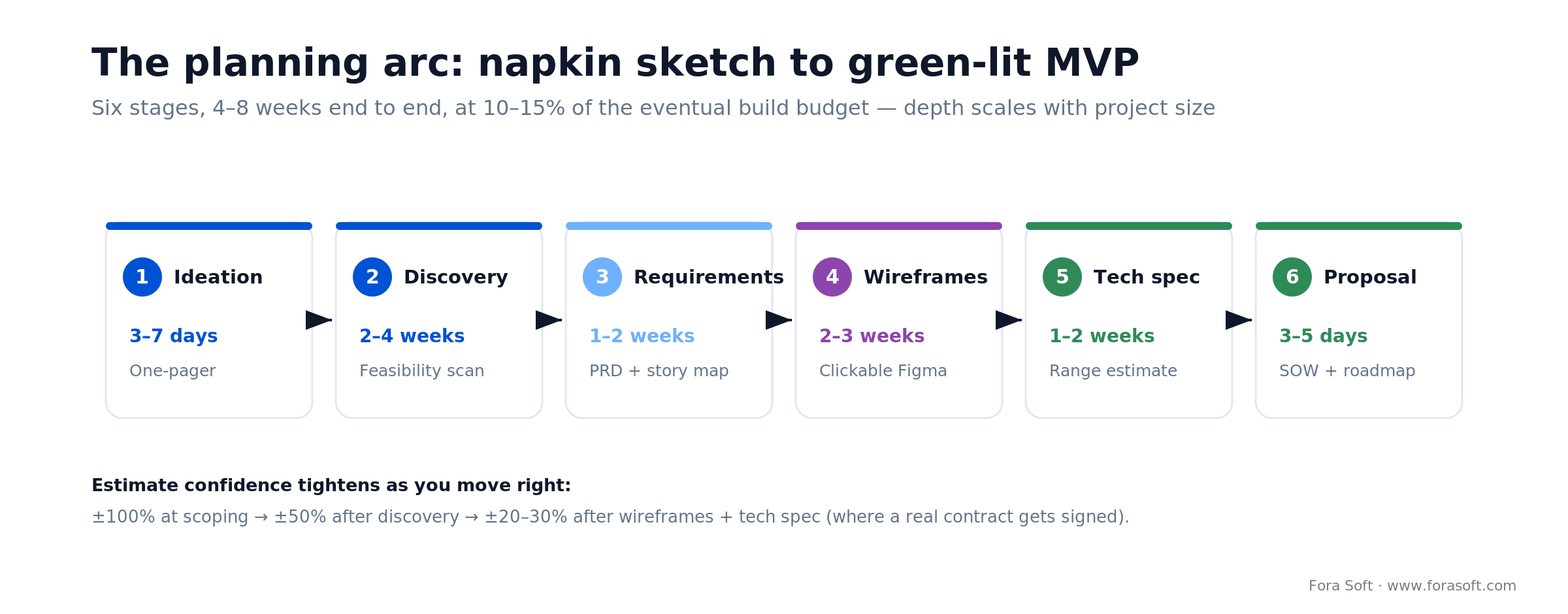

A full planning arc looks the same whether the project is $50k or $500k — only the depth of each step changes. Below is how we structure it at Fora Soft, with the typical time-boxes we use with founders.
| Stage | Duration | Key deliverable | Who signs off |
|---|---|---|---|
| 1. Ideation & scoping | 3–7 days | One-pager, problem statement, rough budget band | Founder |
| 2. Discovery | 2–4 weeks | User research, competitive map, tech feasibility | Founder + tech lead |
| 3. Requirements | 1–2 weeks | PRD, user-story map, MoSCoW matrix | Founder + PM |
| 4. Wireframes & prototype | 2–3 weeks | Clickable Figma prototype, user-flow diagrams | Founder + design lead |
| 5. Tech spec & estimate | 1–2 weeks | Architecture, API contracts, range estimate | Founder + architect |
| 6. Commercial proposal | 3–5 days | SOW, phased roadmap, team composition | Founder + vendor leads |
Total: typically 4–8 weeks end-to-end, at 10–15% of the eventual build budget. If someone offers to skip stages 2–4 to get you “building faster,” they are selling you rework. This structure complements our broader step-by-step product development process, which covers what happens after planning ends.
Discovery — the highest-ROI two weeks of the entire project
Discovery is where a vague “Uber for X” turns into a scoped product. It is ~10–15% of project cost and routinely saves 3–5× its cost in avoided rework. Skipping it is the most common self-inflicted wound we see in founders who have been burned by a previous agency.
What happens during discovery
1. Stakeholder interviews. 30–60 minutes with each of: the founder, 3–5 target users, any domain expert (medical, legal, financial), any operations owner who will run the thing day-to-day. Output is a synthesised pain-point map.
2. Competitive scan. The top 5–7 direct competitors plus 2–3 adjacent products, reviewed for features, pricing, gaps, and review complaints. Output: a feature-parity matrix and a list of “do not copy this” patterns.
3. Technical feasibility. A solutions architect stress-tests the idea against real-world constraints: API availability, integration cost, scale assumptions, compliance load. Output: a one-page risk note.
4. Opportunity sizing. Realistic numbers on market size, pricing, revenue model, unit economics. We draw from public benchmarks wherever possible — our app revenue playbook has the distribution data.
5. Hidden-requirements sweep. Negative scenarios, error handling, regulatory requirements (GDPR, HIPAA, WCAG 2.2), scalability assumptions, i18n/localization, analytics, support flows. About 30% of the requirements we end up writing come from this sweep alone.
Reach for a dedicated discovery sprint when: you have never built software before, or your last product shipped late because “scope kept changing.” Discovery is the tool for fixing that at the root.
PRDs, user stories, and the art of writing good requirements
Requirements are where projects live or die. The core deliverable is a Product Requirements Document (PRD) — one source of truth that captures problem, audience, scope, features, acceptance criteria, constraints, success metrics, and explicit non-goals. Modern PRDs are lightweight (10–30 pages, not 150) and versioned in the same tool the team uses daily (Notion, Confluence, Linear docs).
User stories that a developer can actually build from
The standard template holds up: “As a [specific user], I want to [action] so that [outcome].” The part founders always miss is the acceptance criteria — the observable checks that say the story is done.
STORY: Guest checkout for the storefront As a first-time visitor I want to check out without creating an account So that I can buy quickly and decide later whether to register ACCEPTANCE CRITERIA: - [ ] User can complete a purchase with email + shipping only (no password) - [ ] After payment, user sees a one-click "Save my info" CTA - [ ] If user abandons at payment, email is captured for recovery flow - [ ] Order is linkable to a created account later via email match - [ ] Feature can be toggled off per-store via a feature flag - [ ] Analytics event "guest_checkout_completed" fires with order_id OUT OF SCOPE: - Guest wishlists (v1.1) - Guest order tracking dashboard (v1.1)
MoSCoW — the prioritization frame founders forget

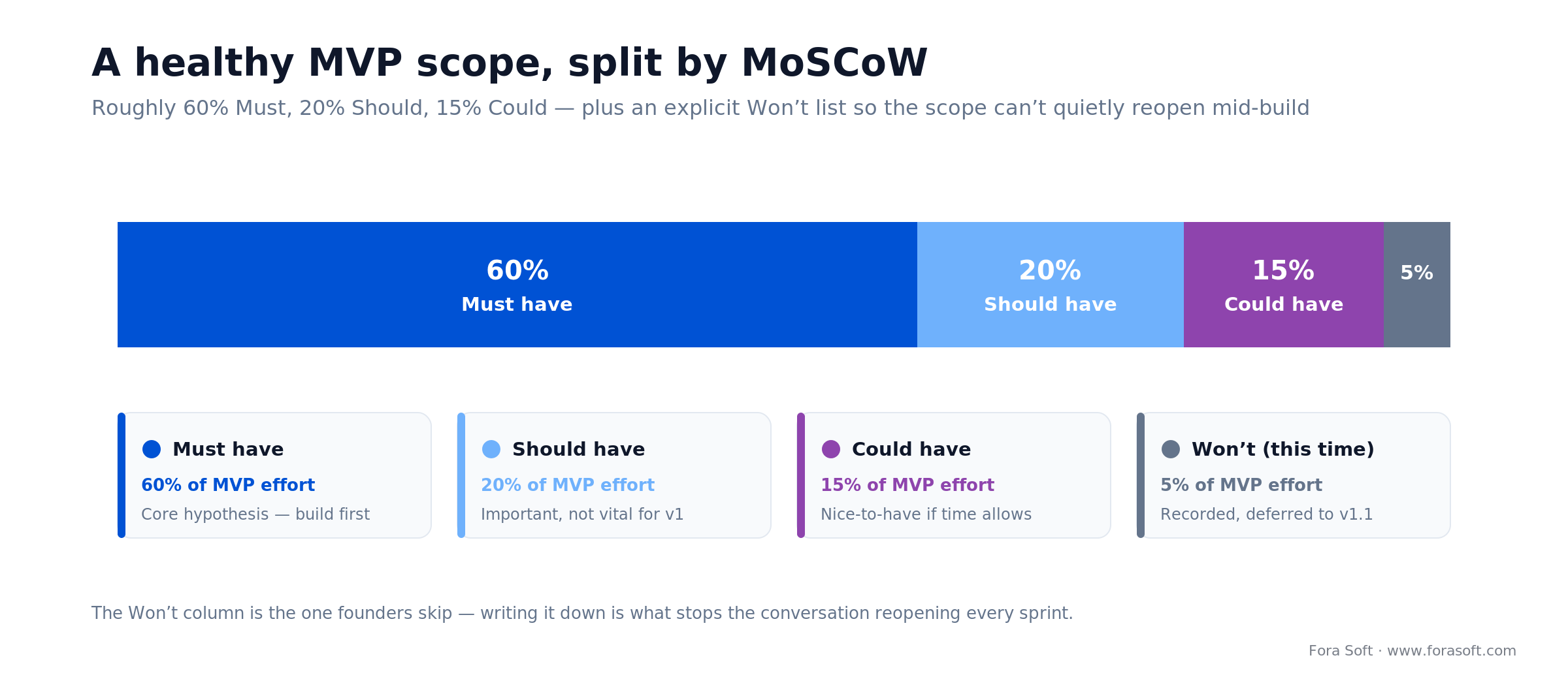

MoSCoW splits every requirement into Must, Should, Could, and Won’t. “Won’t” is the critical one — it records the features you consciously decided to not build, so the conversation does not reopen mid-sprint. A healthy MVP has roughly 60% Must, 20% Should, 15% Could, and an explicit Won’t list.
Scope creep, the single biggest schedule killer, is simply what happens when your Must list grows mid-build without a matching extension to the budget or timeline. Keep the list frozen after planning; route every new idea through formal change control. For more on what happens when the estimate starts sliding, see our guide on why time estimates fail.
Wireframes, mockups, and prototypes — what each one is for
These three words get used interchangeably. They shouldn’t be. Each answers a different question, is built at a different speed, and is used at a different phase.
| Artifact | Fidelity | Question it answers | Typical tool |
|---|---|---|---|
| Wireframe | Low (grey boxes) | Where does each thing live on the screen? | Figma, Whimsical, Miro |
| Mockup | High (final visuals) | What will it look like when finished? | Figma, Sketch, Adobe XD |
| Clickable prototype | Low or high | Does the flow make sense? Can users do the job? | Figma prototype, Framer, ProtoPie |
| Design system | Production-ready | How will this scale to v2, v3, v4? | Figma Library, Storybook |
Our deeper wireframing guide covers the tradeoffs in detail; the short version is that a clickable prototype — even a low-fidelity one — is the single most valuable artifact in the entire planning phase. It catches design issues when fixing them is almost free, and it replaces 80% of future “wait, I thought it would work differently” change requests.
Need a clickable prototype before committing to a build?
Fora Soft runs 3-week prototype sprints with a senior product designer and an Agent Engineering pair — typical output: 20–40 Figma screens plus a tested clickable flow.
MVP scoping — what to include and what to cut
The definition matters. Eric Ries’s original phrasing — “the version of a new product that allows a team to collect the maximum amount of validated learning about customers with the least effort” — is the one to hold on to. An MVP is not a cheap v1; it is a learning instrument. If it cannot teach you whether the core hypothesis is true, it is not an MVP, no matter how little it costs.
Budget bands and what they buy
Lean MVP (8–12 weeks). One platform (web or mobile), basic auth, 3–5 core flows, one or two third-party integrations, minimal admin, no AI, no regulated features. The goal is “can users do the job end-to-end” — not “does it scale to a million.”
Validated MVP (16–24 weeks). Two platforms (responsive web + iOS or Android), user management, 2–4 integrations, light analytics, basic admin dashboard, onboarding flow. Enough surface area to run a real beta of 100–1000 users.
Scale-ready MVP (24–36 weeks). Full web + native mobile, role-based access, multi-tenant architecture, compliance scaffolding (GDPR or HIPAA), real analytics, payments, admin tooling, localised content. This is what we built for products like AppyBee and Vodeo before their paid launches.
For concrete cost ranges and how they map to features, our 2026 mobile app development cost guide breaks down the same spectrum on the mobile side. Because we use Agent Engineering for spec drafting, boilerplate generation, and test coverage, Fora Soft estimates on equivalent scope tend to land faster and lower than traditional agency quotes — we pass that saving through rather than holding it as margin.
Reach for a Lean MVP when: you are still validating whether anyone will pay at all. Reach for a Scale-ready MVP only when you have a paying customer who needs a specific SLA on day one.
Estimation — why every honest estimate is a range

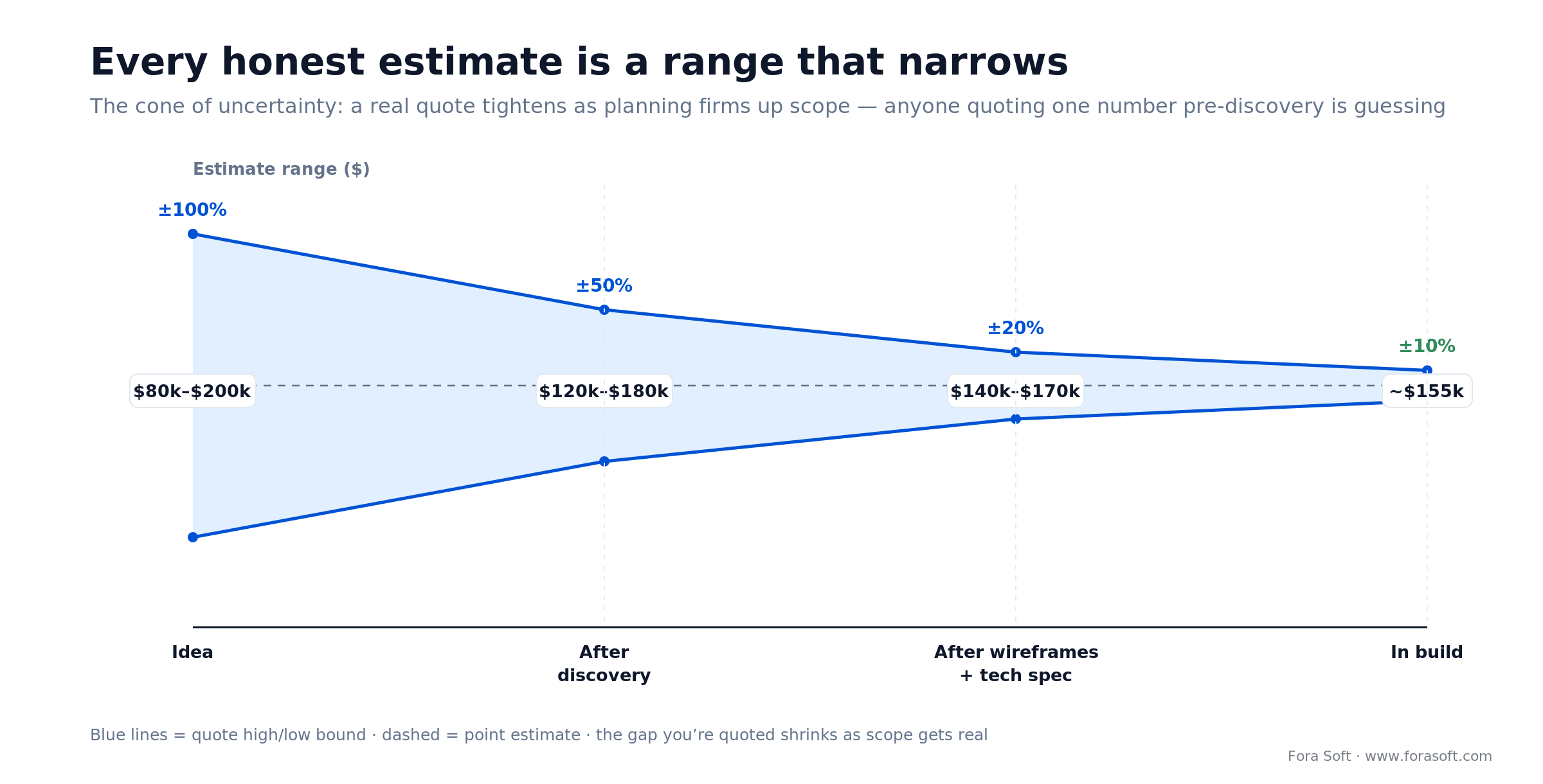

Anyone handing you a single-number quote before planning is closed is either lying or about to lose money. Estimates are probability distributions, not points. The professional way to quote is a confidence interval (P50 / P90) that narrows as planning progresses.
At scoping (before discovery): order-of-magnitude band, ±100%. Example: “$80k to $200k.” Anything tighter is pretend-accuracy.
After discovery: ±50%. Example: “$120k to $180k.” At this stage we know the shape of the work and the main risks.
After wireframes + tech spec: ±20–30%. Example: “$140k to $170k, with a $10k contingency.” This is where a real contract gets signed.
For story-level estimation inside the build, most agile teams use relative story points (Fibonacci 1, 2, 3, 5, 8, 13) or T-shirt sizes (XS/S/M/L/XL) with Planning Poker calibration. Absolute hour estimates for individual stories are almost always wrong; relative estimates are right on average and converge on correct velocity within 2–3 sprints.
Agile, Waterfall, or Hybrid — pick by constraint
The best process is the one that matches how certain you are about the scope.
Waterfall makes sense when requirements are truly fixed (regulated medical devices, aerospace, embedded firmware, infrastructure migrations) and the cost of a late change is catastrophic. A proper waterfall project needs 20–40% of total effort in planning. For most consumer and B2B software, this is overkill.
Agile (Scrum, Kanban, ShapeUp) is the default for new products. It assumes you will learn as you go and bakes that learning into 1–2 week cycles. Planning is continuous: a heavy discovery up front, then lightweight per-sprint planning for as long as the project runs. 85% of the projects Fora Soft ships use some flavour of Agile.
Hybrid (a fixed architecture with an agile feature build on top) is the right pick when part of the system is truly fixed — a hardware device, a certified backend, a legally-mandated workflow — but the UX on top needs to evolve. Plan the fixed parts waterfall-style, run the rest agile.
Five risks that kill software projects — and planning-stage mitigations
1. Scope creep. The most common killer. Mitigate by freezing the MVP scope after planning, using MoSCoW, and running every change request through a formal change-control note with cost and time impact. Our guide on expectation-reality mismatch covers the common failure modes.
2. Vague requirements. Every story must have acceptance criteria and a single owner; every requirement must trace to a user need. This alone eliminates about half of the rework risk.
3. Over-optimistic estimates. Use 3-point PERT or T-shirt sizing with explicit confidence intervals; add a 10–20% contingency buffer for anything novel. Pad for learning curves on unfamiliar tech.
4. Single points of failure. The “bus factor” problem — one person knows everything. Mitigate with paired development, written documentation, and a mandatory 30-minute weekly knowledge-sharing slot. A good vendor will have this built in.
5. Deferred QA. “We will test it at the end” is a classic killer. Testing starts at the wireframe stage (flow sanity), runs through unit tests in the build, and includes usability testing on the prototype. Our testing-at-every-stage guide has the longer version.
Picking the right partner — red flags and green flags
A good planning partner is worth paying for. Here is how to tell the difference in a 45-minute sales call.
Red flags
1. A fixed-price quote before discovery. They either do not understand the risk or they are pricing to win and will rebill you on change orders.
2. “We can do anything.” A mature vendor turns down some projects because they recognise scope they cannot execute well. Universal competence is a sales pitch, not a capability.
3. No discovery phase in the proposal. If they quote a build price with no plan for scoping, they plan to learn at your expense.
4. No portfolio or named references. Case studies should be specific and verifiable: real clients, real metrics, real outcomes. Vague “NDA forbids names” for every project is a tell.
5. Missing line items in the estimate. No QA budget, no discovery, no DevOps, no contingency — you will pay for those later, it just will not be in the original quote.
Green flags
A good partner asks hard questions before promising anything, pushes back on bad ideas, can show detailed technical specs from prior work, names three reference clients on the first call, and itemises QA, DevOps, discovery, and contingency explicitly. They also volunteer risks you had not thought of — and they are honest about where they are weak.
Engagement models — in-house, agency, dedicated team, or freelancer
Freelancer. 30–50% cheaper than an agency on a single task, fastest to spin up, zero overhead. Cost: you become the project manager, the bus factor is one person, ongoing support is on you. Right choice for a well-scoped feature or a 2–3 week spike.
Agency (fixed-scope). Full team, guaranteed delivery, formal contract. Right when you need 5+ specialists for a scoped build and you are not looking for a long-term partnership. Cost: 30–60% premium over direct engineering.
Dedicated team (our most common model). A long-running extension of your team — developers, QA, designer, PM — that owns the product over months or years. You keep the IP, the rituals, and the velocity; the vendor handles hiring, onboarding, and performance. Cost: comparable to mid-sized agency, faster iteration, lower turnover. This is what we offer via our dedicated development team service.
Staff augmentation. Add 1–3 specialists to an existing in-house team. Good when you have leadership but a capacity gap; bad when you need end-to-end ownership.
In-house. Long-term, deep-domain products with stable funding. Slow to hire, expensive to scale, best outcomes when the product is the company.
How AI and Agent Engineering are changing the planning phase
2025–2026 is the first cycle where AI tools are materially compressing the planning phase. The net effect for a Fora Soft engagement is roughly a 30–40% reduction in discovery time at comparable or better output quality. Where the savings actually come from:
1. PRD drafting. Tools like Figma AI PRD, Miro AI, Beam.ai, and purpose-built Claude agents turn raw research notes, transcripts, and sketches into a structured PRD draft in hours instead of days. The draft still needs human editing, but you start the conversation from version 2, not version 0.
2. Research synthesis. AI-assisted interview synthesis clusters 20 user-interview transcripts into themes in minutes. The analyst still validates the clustering, but the grind of reading and tagging drops by an order of magnitude.
3. Competitive analysis. An agent can scrape 20 competitor websites, pull pricing, feature matrices, and review themes, and hand back a structured comparison overnight. The analyst validates; the drudge work disappears.
4. First-pass wireframes. AI-generated wireframes from a text description or a screenshot are now usable as a starting point. Expect to redo 60–70% of them, but you are editing, not inventing.
5. Estimate stress-testing. Agent-assisted estimation can sanity-check story-point distributions against historical velocity from similar projects, catching optimistic outliers before they get baked into a proposal.
What has not changed: the judgement calls — which user need is real, which feature is a distraction, which risk is dealbreaker — still require humans with domain depth. AI is a force multiplier, not a replacement for a senior product strategist.
Engagement model comparison at a glance
| Model | Ramp-up | Cost signal | Ownership | Best fit |
|---|---|---|---|---|
| Freelancer | Days | Cheapest per hour | You are the PM | Scoped spikes, specialty skills |
| Fixed-scope agency | 2–4 weeks | Premium | Vendor-heavy | One-shot scoped builds |
| Dedicated team | 1–3 weeks | Mid-premium | Shared | Long-running products, MVP-to-scale |
| Staff augmentation | 1–2 weeks | Per head | Fully yours | Capacity gaps in a mature team |
| In-house | 3–6 months | Highest fully-loaded | Fully yours | Core competency, long horizon |

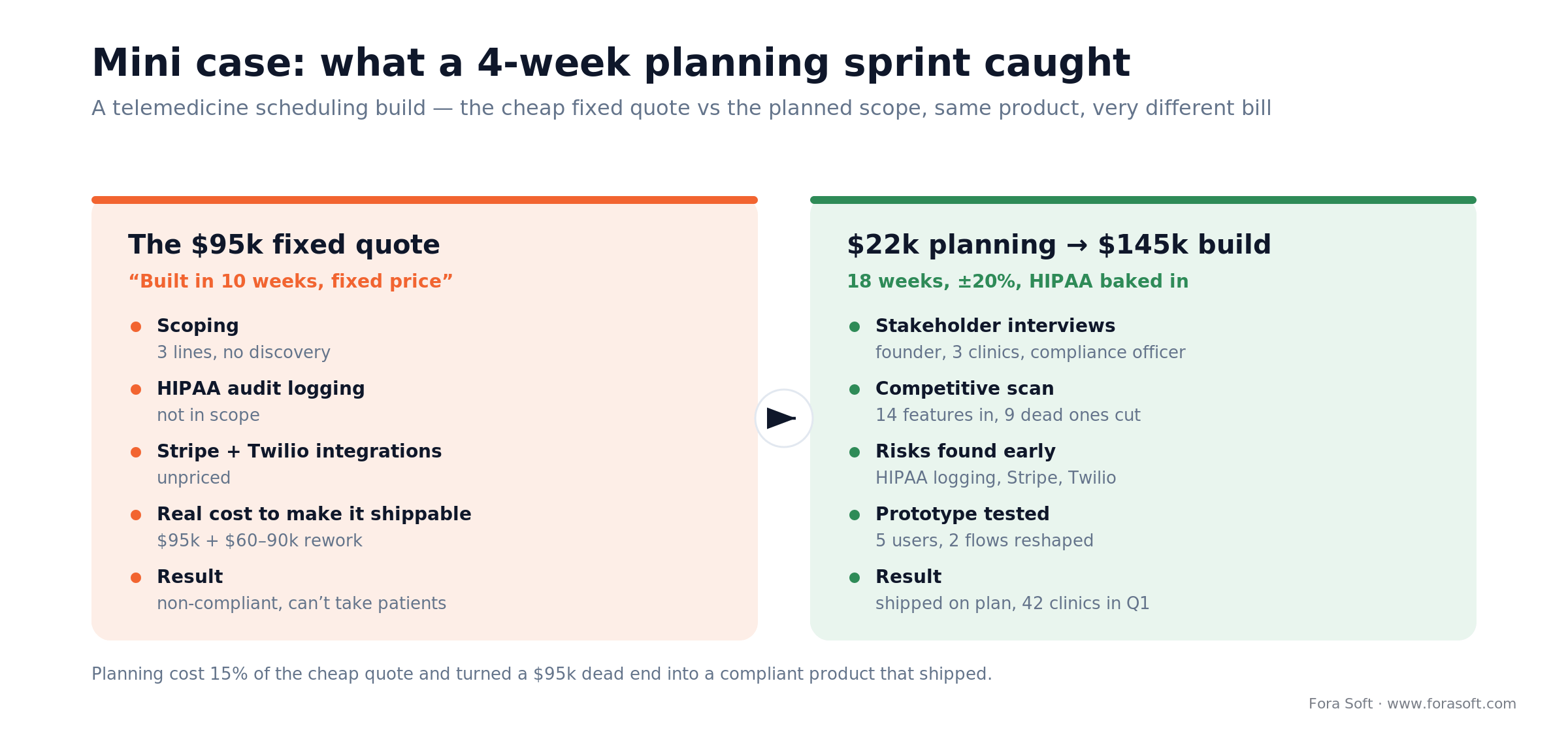

Mini case — how a 4-week planning sprint saved a $180k build
Situation. A founder came to us with a one-page idea for a telemedicine scheduling product and a three-line competitor’s quote: “we can build it in 10 weeks for $95k, fixed price.” Another agency was offering $160k for 16 weeks. The founder was leaning toward the cheaper quote.
4-week planning sprint. Our team ran stakeholder interviews with the founder, three prospective clinics, and a HIPAA compliance officer. Competitive analysis surfaced 14 features in leading products and 9 that were actively being removed because nobody used them. Technical feasibility identified two critical integrations (Stripe for deposits, Twilio for SMS reminders) and one real risk (HIPAA-grade audit logging, which the $95k quote had not scoped). Clickable prototype ran through five users; two flows were reshaped end-to-end.
Outcome. Planning cost: $22k. Post-plan build estimate: $145k ± 20% over 18 weeks, with HIPAA compliance baked in and a clean MVP scope. The cheap $95k quote would have produced a non-compliant product needing a $60–90k rework before it could take real customers — a conservative estimate based on remediation projects we have run. The founder shipped on plan, with 42 clinics signed in the first quarter. Want a similar planning sprint for your idea?
Would a 4-week planning sprint catch what other vendors missed?
We run these with a senior product strategist, a solutions architect, and Agent Engineering support — typical cost lands 20–30% below equivalent agency scoping because we let the agents do the drudge work.
A decision framework — software planning in five questions
Q1. Do you have a written one-pager stating the problem, target user, and core hypothesis? If not, stop and write one before talking to any vendor. It will save 2–3 weeks of miscommunication.
Q2. Has someone outside your team tried to tear the idea apart? Invite a sceptic into discovery. Founders who cannot name their top three risks are about to fund someone else’s learning.
Q3. Is your MVP definition written as a hypothesis, not a feature list? “If we build X, users will do Y within Z days” — if you cannot phrase it like that, you do not have an MVP, you have a wishlist.
Q4. Have you priced the full stack, not just the build? QA (typically 20–30% of build), DevOps (~10%), discovery (~10–15%), contingency (~10–20%), ongoing support (~15–20%/year of build). Missing any of these turns a $150k project into $250k.
Q5. Do you have a plan for what happens after the MVP ships? A planned v1.1 and v1.2 force honest MVP scope — it is easier to leave a feature out when you know exactly when it will get in.
Five planning pitfalls to avoid
1. “We already know what users want.” You do not. Even when you are right, you are wrong about the edges. Run discovery anyway — the ROI is too high to skip.
2. Freezing the plan at the first estimate. Early numbers are order-of-magnitude; planning should tighten them with data, not lock them in. Founders who demand a single-number quote upfront get either a lie or a padded number.
3. Conflating MVP with v1. Every feature you add to the MVP because “users will expect it” is a bet that users will not tolerate the absence. Half those bets are wrong. Ship smaller, learn faster; see our guide on cutting costs without cutting quality for the disciplined version.
4. Cheapest-quote shopping. A quote 40% below the field either misunderstands the work or will come back for a change-order tax. Compare quotes on scope parity, not sticker price.
5. Not planning the post-launch. Deadlines slip when no one has mapped what happens after ship day. Analytics, support flow, on-call rotation, paid-ads budget, update cadence — they all need line items in the plan. Without them, the launch lands and nothing happens. See our notes on rescuing slipping deadlines for more on that dynamic.
KPIs — how to measure planning quality
Quality KPIs. Estimate variance (actual vs. planned build time, target ±20%), defect escape rate (bugs found post-launch per 1k LoC, target < 0.5), rework ratio (stories reopened after sign-off, target < 10%). These tell you whether the plan matched reality.
Business KPIs. Time-to-first-customer (weeks from MVP ship to first paid user, target < 8), activation rate (% of signups who reach the aha moment, target > 30%), cost per learning (planning + build spend per validated hypothesis). These tell you whether the project is actually a business.
Process KPIs. Discovery duration (target 2–4 weeks), planning-to-build spend ratio (target 10–15%), change-order volume per sprint (target < 2), on-time sprint completion (target > 80%). These tell you whether the team is executing well.
When NOT to run a heavy planning phase
Planning intensity should match project risk. A few scenarios where the usual advice is wrong:
1. A true throwaway prototype. If the only goal is to show a 10-minute demo to an investor and then delete the code, write a half-page spec and ship a Bubble/Retool prototype in a week. Do not build a PRD for a throwaway.
2. Internal tool under $20k. One user, one workflow, known constraints. A half-day of scoping and a clear acceptance checklist is enough.
3. Incremental features on a mature product. If the platform, audience, and design system are settled, planning shrinks to user stories + acceptance criteria + rollout plan. The full discovery arc is overkill.
In every other case — new products, new markets, new user segments, new compliance regimes — the discipline described above is the cheapest insurance you can buy.
FAQ
How much should software planning cost as a percentage of the total project?
Budget 10–15% of the eventual build cost for planning. On a $150k project that is $15–22k. Agencies that quote without a planning line item are hiding the cost and will bill it back as change orders. Planning routinely saves 3–5× its cost in avoided rework.
How long should the discovery phase take?
Typically 2–6 weeks. Simple, single-platform products: 2–3 weeks. Medium complexity with several integrations: 4–6 weeks. Regulated or enterprise: 6–8 weeks. With AI-assisted research synthesis and PRD drafting, mid-range projects now complete discovery in 3–4 weeks.
What is the difference between a wireframe and a prototype?
A wireframe is a static, low-fidelity layout — grey boxes that show where things sit. A prototype is interactive: you can click it, fill forms, navigate, and test the real flow. Wireframes answer “where”; prototypes answer “does this actually work.” You need both for a serious project.
What should be in an MVP?
Only features that are needed to test the core value hypothesis. Everything else — admin panels, analytics, export, nice-to-have flows — gets deferred. A good MVP has one or two must-do user stories, the infrastructure to observe what users actually do, and a feedback loop back to the founder.
Can AI write my PRD for me?
AI can draft a reasonable first version in hours if you feed it good inputs — interview transcripts, market research, and a clear problem statement. You still need a human product strategist to validate the clustering, catch missing edge cases, and make the hard prioritization calls. Treat AI as a force multiplier, not a substitute.
When should I pick Agile vs. Waterfall?
Use Agile for new products where you expect to learn as you go — which is almost every consumer and B2B software project. Use Waterfall only when scope is truly fixed and the cost of a late change is catastrophic (regulated medical devices, aerospace, embedded firmware). Hybrid is right when hardware or compliance is fixed but the software UX must evolve.
How do I evaluate a software development partner?
Ask for three named references with published case studies, ask them to walk you through their discovery deliverables from a previous client, ask how they handle scope changes contractually, and ask for an itemised estimate that includes QA, DevOps, discovery, and contingency as separate lines. Vagueness on any of those four is a red flag.
How much should I add as contingency?
10–20% of the build budget is standard. Closer to 10% for well-scoped incremental work on a mature product; closer to 20% for a new product, new integrations, or anything touching regulated data. Do not agree to a contract that has zero contingency — it just means the vendor will bill every edge case as a change order.
What to Read Next
Design
The wireframing guide for software projects
Low-fidelity to high-fidelity, clickable prototypes, common pitfalls — the deeper dive into visuals.
Process
Our step-by-step product development process
What happens after planning — our full delivery workflow from design through launch.
Estimation
Why developer time estimates don’t always work
A candid look at uncertainty, confidence intervals, and how to manage estimate drift.
Budget
How to cut costs without cutting quality
Smart scope trade-offs that preserve the MVP hypothesis and still keep the budget sane.
Cost
2026 mobile app development cost guide
Realistic cost ranges, budget drivers, and how AI tooling changes the numbers in 2026.
Ready to plan a software project that ships on time and on budget?
A well-run planning phase is not overhead — it is the cheapest insurance you will ever buy against the 50–70% failure rate baked into the software industry. Ten to fifteen percent of the project budget, invested upfront in discovery, requirements, wireframes, and a clickable prototype, repays itself three to five times in avoided rework and prevented dead-ends.
The plays are unchanged: a structured discovery, a written PRD, a user-story map with acceptance criteria, a clickable prototype, a MoSCoW-ordered scope, a range-based estimate, a named team, and a freeze-and-change-control process. Agent Engineering makes each of those faster and cheaper than it used to be; it does not make them optional. If you want a partner who treats planning as the highest-ROI work in the project, that is what Fora Soft has done on 625+ products and counting.
Let’s turn your idea into a shippable plan.
30-minute call with a senior Fora Soft strategist — you leave with a scoped MVP outline, a realistic budget band, and a prioritized risk list whether or not you end up working with us.
